Job cost, WIP, and schedule risk from Procore and ERP—one project grain

Construction controllers fight when Procore (or similar) percent-complete, ERP committed cost, and site schedule tools disagree on job number grain. We model job cost and WIP in Power BI so forecast final cost and cash calls use the same project key before monthly WIP meetings.

NDA-readyFixed-scope first releaseBusiness + IT handover
Example: Project controls dashboard — cost-to-complete, schedule variance, margin, and safety (illustrative).
  • Operating since 2012
  • Microsoft Power BI specialists
  • NDA-ready data handling
  • Fixed-scope first releases
  • Independent — not affiliated with Microsoft

Reporting challenges

Typical friction when CRM, ERP, and operational tools are reported separately.

  • 01Cost-to-complete in project controls does not match job-cost actuals in accounting until month-end.
  • 02Change orders sit in one system while commitments and vendor invoices sit in another.
  • 03Schedule variance and safety incidents never appear beside margin risk on the same portfolio view.
  • 04Field payroll and equipment costs are pasted into Excel before leadership reviews.
  • 05Multi-entity construction groups cannot compare projects because each division defines gross margin differently.

How Power BI for Construction solves it

What changes when those systems feed a governed Power BI model.

  • Connect project controls and job-cost ERP into Power BI for construction with one cost-to-complete and margin model.
  • Show portfolio RAG: budget, committed cost, change orders, schedule, and cash in one scorecard.
  • Give PMs and finance the same forecast definitions before the monthly review.
  • Automate exception alerts when margin or schedule variance crosses thresholds.
  • Scale the same Power BI model across regions and entities with consistent security.

Why this work matters commercially

03

Commercial considerations

Construction organizations already manage the business in project controls, job-cost accounting, estimating, payroll, and procurement. The reporting problem is usually not “we need another chart”—it is that CRM, ERP, and operational extracts disagree on timing, filters, and owners before every meeting.

PMs track jobs in project software while finance closes in ERP—margin surprises show up after the monthly pack. Power BI for Construction only works when those systems of record feed one governed semantic model with documented KPI definitions.

Power BI Analytics scopes the first release around the construction decisions that currently wait on manual packs—then connects the right source systems, validates totals, and lands the report in a real operating cadence.

Who this is for

Built for leaders who need dependable numbers in real operating conversations—not another unused dashboard.

01Construction executives who need one operating view across CRM/ERP and plant or field systems
02Finance partners tired of reconciling conflicting system extracts
03Operations and functional managers who need earlier exception visibility
04IT and analytics teams responsible for maintainable Power BI on Microsoft

How value is measured

We establish a baseline before delivery so ROI is discussed in operating terms, not slideware.

01

Time saved

Measure hours currently spent assembling construction reporting packs, reconciling totals, and answering “which number is correct?”

02

Decision speed

Track how many days earlier leaders can see exceptions, variances, or forecast risk after the release.

03

Control and trust

Count disputed metrics, failed refreshes, and unmanaged workbooks replaced by governed models.

04

Adoption

Confirm the intended audience actually uses the report in the meeting or process it was designed for.

Where construction data already lives

PMs track jobs in project software while finance closes in ERP—margin surprises show up after the monthly pack. Power BI consulting connects these systems of record into one governed reporting model.

01

Project controls / ERP (Procore, Vista, Spectrum, SAP)

budget, committed cost, change orders

02

Accounting / job cost

actuals, billing, cash

03

Estimating

bid vs award baselines

04

Payroll / field time

labor cost and productivity

05

Procurement / subcontract

commitments and vendor risk

KPIs that support action

01

Cost-to-complete

Forecast cost vs approved budget from project controls + actuals.

02

Schedule variance

Planned vs actual progress on the portfolio.

03

Gross margin

Profitability by project, client, or division.

04

Safety incidents

Recordables and leading indicators alongside delivery risk.

Recommended dashboards

Recommended construction dashboards

Power BI for Construction patterns we tailor to your systems, owners, and review cadence. Click any preview to expand.

Dashboard

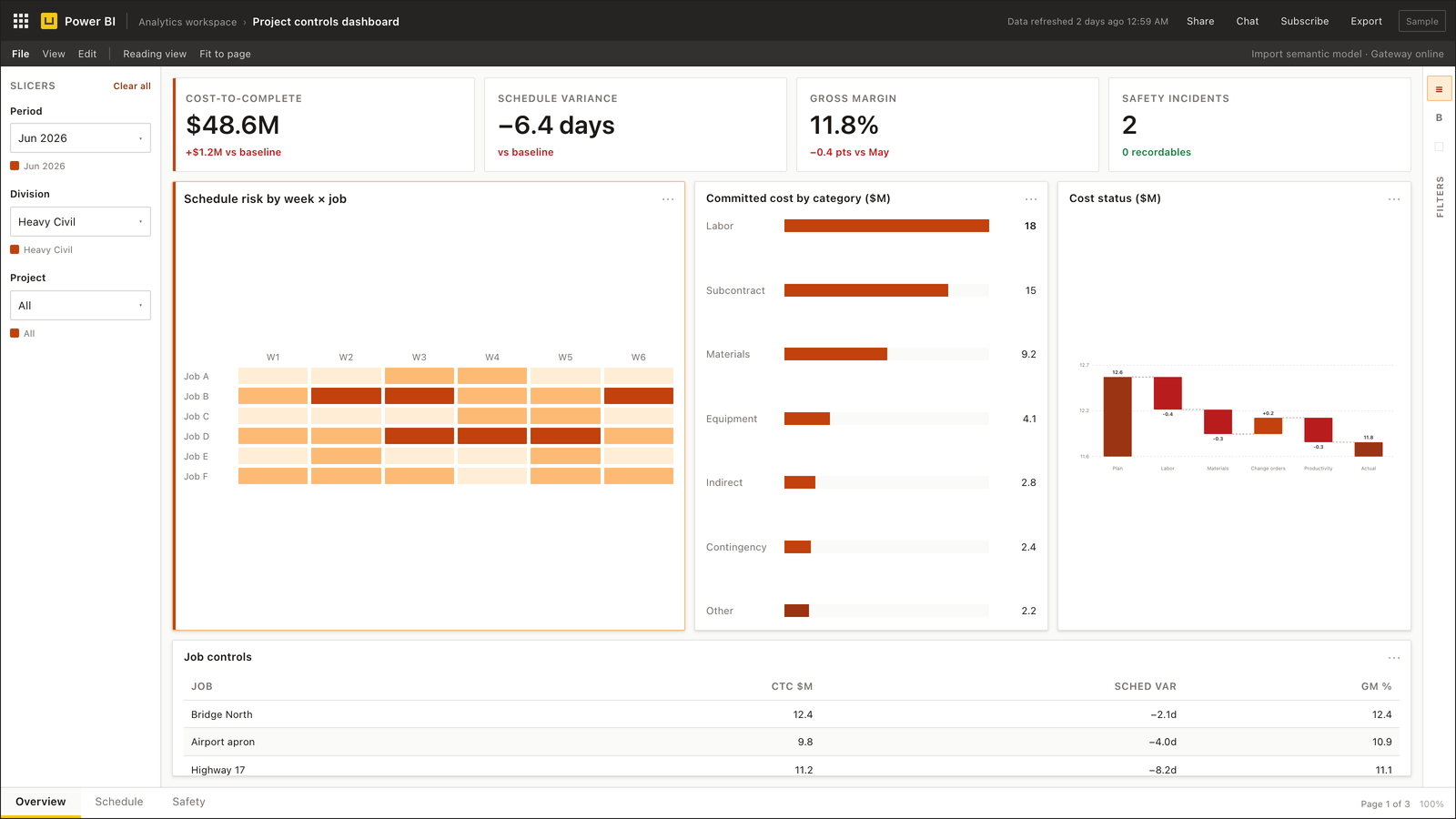

Project controls dashboard

Budget, committed cost, change orders, and forecast margin.

  • Connected to project controls, job-cost accounting, estimating, payroll, and procurement
  • Thresholds and owners
  • Drill to operational detail

Dashboard

Portfolio delivery dashboard

Schedule health, risk, resource demand, and cash flow.

  • Connected to project controls, job-cost accounting, estimating, payroll, and procurement
  • Thresholds and owners
  • Drill to operational detail

Operating cadence

Reporting only creates value when it lands in a real review rhythm.

Daily or shift exceptions from operational systems into Power BI
Weekly construction performance review with owned actions
Monthly executive scorecard with variance commentary
Quarterly model improvements tied to adoption and ROI

Example reports

  • 01Construction executive scorecard from governed Power BI measures
  • 02Construction operations exception pack by site, team, or account
  • 03Variance and root-cause drill-through tied to source systems
  • 04Trend, forecast, and owner-threshold report for weekly reviews

What improves

  • Connect project controls and job-cost ERP into Power BI for construction with one cost-to-complete and margin model.
  • Show portfolio RAG: budget, committed cost, change orders, schedule, and cash in one scorecard.
  • Give PMs and finance the same forecast definitions before the monthly review.
  • Automate exception alerts when margin or schedule variance crosses thresholds.
  • Scale the same Power BI model across regions and entities with consistent security.

Frequently asked questions

05

Buyer questions answered

Yes when ProjectId/JobNumber is conformed across Procore cost codes and ERP GL/job cost. We Import Procore exports or API extracts plus ERP commitments through a gateway, then calculate WIP using the signed percent-complete rule—not three Excel versions of EAC.

A conformed cost-code dimension with job-specific mappings; facts stay at cost-code line grain. Expanding nested Procore JSON in Power Query after the fold boundary is a common Status = Failed cause—stage flattened tables first.

RLS roles filter ProjectId via Entra group membership. View as tests cover a PM on two jobs, a regional director, and finance. Bidirectional relationships ‘to make the slicer work’ are rejected if they widen project visibility.

Schedule (Primavera/MS Project exports) often lands later than ERP journals. We document intentional lag and show ‘as-of’ timestamps on the dashboard. Do not DirectQuery live scheduling DBs for board WIP—Import with a known cutoff.

Late CO postings need a watermark/modified date if using incremental refresh on large job-cost facts. Without it, closed-period WIP silently drifts. We reconcile ERP job cost totals to Power BI after each month-end before certifying the model.
